Country Hills Blvd. N.E. widening project

Keeping Calgarians moving safely Country Hills Blvd N.E. widening project

Building a safer road today, while preparing water infrastructure for tomorrow

Project overview

We are widening around 800 metres of Country Hills Blvd. N.E. to improve travel, support safety and prepare this corridor for future growth. This work will help reduce delays, improve road safety and strengthen an important route in northeast Calgary.

This project includes:

  • Widening about 800 metres of road between Barlow Trail and 36 St. N.E.
  • Pre-installing of a section of water feeder main
  • Moving overhead power and communications lines underground
  • Building new sidewalks and pathways
  • Adding storm drains and utility lines
  • Installing streetlighting and upgrading intersections with traffic signals
  • Landscaping and site restoration
  • Restoring pavement from 36 street to Metis Tr. N.E.

How this project will improve travel for you

  • Better traffic flow and less congestion, getting you where you need to go faster

  • Safer travel for drivers and emergency services

  • Provide infrastructure that supports the growth in your community

Project location

Country Hills Boulevard between Barlow Trail and 36 St. N.E.

Ward: 5

Project phase

Latest updates

May 2026

Crews have started building the new road and related improvements. This means the project has moved from early utility and site preparation into visible roadway construction.


As of December 2025, we:

  • Removed old overhead power and communications lines and poles.
  • Built underground ducts and installed new power and communications lines.
  • Built a paved, lighted temporary detour road.
  • Installed new deep utilities.
  • Installed a new water feeder main for a future connection.

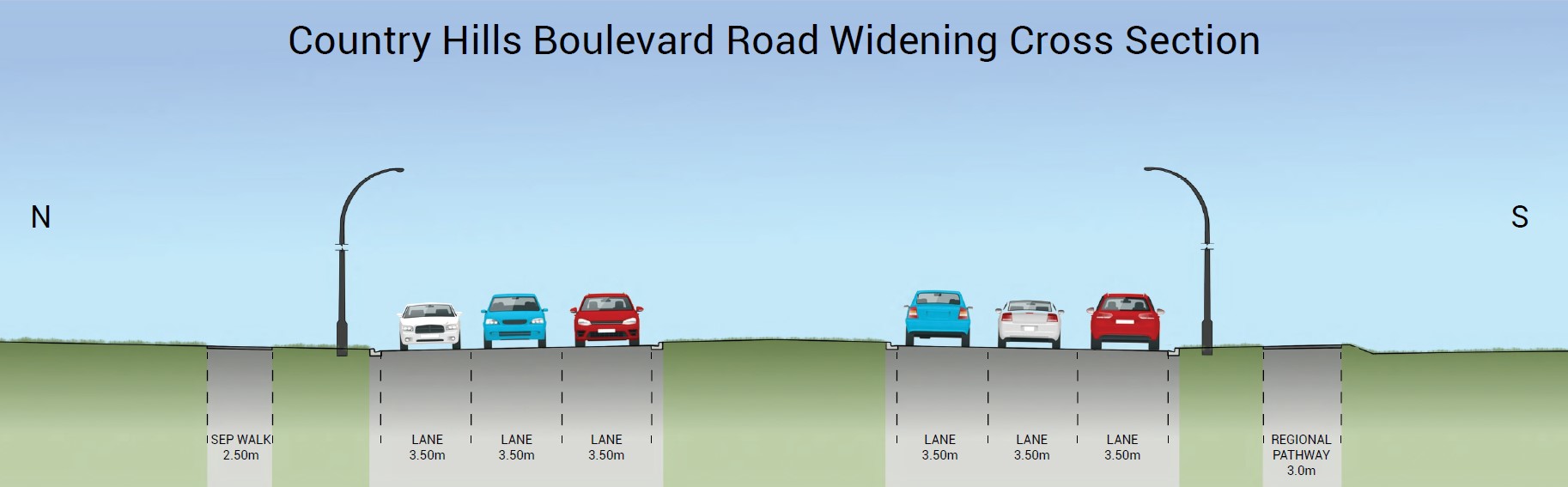

Country Hills Blvd Cross Section

Timeline

Construction began May 2025 and is expected to be complete by fall 2026. Weather and site conditions could affect construction work. Any major changes to the timeline will be shared on this webpage. See the timeline below to learn about how we are making progress.

upcoming-item

Category Icon and Label

October 2026 Final touches

Start Date | End Date

Lights, sidewalks, and trees will be finished.

upcoming-item

Category Icon and Label

September 2026 Road fully opened

Start Date | End Date

The second half of the road is completed and all six lanes open.

upcoming-item

Category Icon and Label

July 2026 First half of the road opens

Start Date | End Date

The first half of the new road opens; traffic moves off the detour.

current-item

Category Icon and Label

April 2026 2026 construction begins.

Start Date | End Date

past-item

Category Icon and Label

2025 Utility & other foundational work

Start Date | End Date

Removed old overhead wires and poles, built new underground lines, added a temporary paved and lit detour road, installed new deep utilities, and put in a new water pipe for future use.

Image gallery

Construction

We know construction affects your daily travel. We are taking steps to reduce disruption  as much as possible. 

Mitigating construction impacts

  • Working in stages

    Crew will work in small sections, to limit delays and keep traffic moving.

  • Providing a detour

    A temporary route will help you get around construction with less disruption.

  • Clear wayfinding

    Signs will guide you safely through the area.

  • Scheduling off-peak work

    Some work will happen at night (9 p.m. to 5 a.m.) to reduce daytime delays.

Outreach and engagement

Two Ward 5 information sessions in 2025 and 2026 shared project information with the community.

Budget and funding

$19 million

Contact

Contact: 311
